Prestressed boundary wall systems

Prestress Precast Boundary Wall

Prestressed precast posts and panels for durable, rapidly installed boundaries across large sites and linear corridors.

Interactive GLB modelCatalogue pages 41-44Drawing-led manufacture
01 / Use prestress efficiently

Slender units need controlled design

Prestressing supports efficient panel geometry, but production, lifting and installed actions must all be covered by the approved design.

  • Panel prestress
  • Handling condition
  • Installed wind action
  • Serviceability limits
02 / Set out the boundary

Long runs amplify small errors

Accurate centres, line and levels are essential so columns receive the panels without forced fitting or uneven joints.

  • Survey baseline
  • Column centres
  • Ground profile
  • Special bays
03 / Prepare foundations

Every column needs reliable restraint

Footing size and depth follow wall height, wind, soil and system design. Foundation concrete must reach the specified condition before erection.

  • Soil bearing
  • Footing geometry
  • Column embedment
  • Concrete readiness
04 / Erect in catalogue sequence

Controlled lifting protects the units

Use approved lifting points and equipment, secure columns, then insert panels in the planned sequence without impact damage.

  • Lifting points
  • Crane reach
  • Column stability
  • Panel seating
05 / Inspect the full system

Finish, security and traceability

Verify line, level, joints, coping or security topping and retain production and installation records for handover.

  • Alignment check
  • Surface inspection
  • Topping details
  • Handover records
Loading product model
Drag to orbit · buttons to zoom · page scroll stays active
01 / 05
Applications

Where this product is considered.

Application cards describe typical use contexts, not automatic suitability. The project team must confirm geometry, loading, exposure, standards and interfaces for the actual location.

01

Railway and highway corridors

Coordinate the product with adjoining construction, access, drainage, safety and the approved project details.

02

Industrial estates and logistics parks

Coordinate the product with adjoining construction, access, drainage, safety and the approved project details.

03

Solar, utility and power sites

Coordinate the product with adjoining construction, access, drainage, safety and the approved project details.

04

Residential and plotted developments

Coordinate the product with adjoining construction, access, drainage, safety and the approved project details.

05

Institutional campuses

Coordinate the product with adjoining construction, access, drainage, safety and the approved project details.

06

Large agricultural and land boundaries

Coordinate the product with adjoining construction, access, drainage, safety and the approved project details.

Catalogue evidence

Product imagery, drawings and schedules.

These supplied catalogue spreads are shown as references for product understanding. Click any panel to inspect it at full size. Approved project drawings remain the controlling documents.

Design inputs

Information to freeze before manufacture.

Prestressing allows slender factory-made panels and posts to form efficient repeated boundary bays. The system reduces on-site casting and curing, but remains dependent on accurate foundations, approved post spacing, lifting methods and project-specific wind and terrain checks. The six inputs alongside form a practical pre-production checklist.

Input 01

Required wall height and bay length

Record the requirement on the current approved drawing or schedule and coordinate it with affected disciplines.

Input 02

Wind, terrain and exposure condition

Record the requirement on the current approved drawing or schedule and coordinate it with affected disciplines.

Input 03

Panel prestress and handling configuration

Record the requirement on the current approved drawing or schedule and coordinate it with affected disciplines.

Input 04

Column foundation and founding soil

Record the requirement on the current approved drawing or schedule and coordinate it with affected disciplines.

Input 05

Gate, corner and stepped-ground details

Record the requirement on the current approved drawing or schedule and coordinate it with affected disciplines.

Input 06

Finish, security and maintenance requirements

Record the requirement on the current approved drawing or schedule and coordinate it with affected disciplines.

Project workflow

From site information to installed unit.

Precast gains programme certainty when survey, design, production, logistics and erection are treated as one connected workflow rather than separate purchases.

01

Survey and peg the boundary alignment

Convert survey and technical inputs into an agreed basis.

02

Approve panels, columns and foundations

Freeze the product geometry, interfaces and required checks.

03

Cast footings at controlled centres

Complete factory production and documented inspection.

04

Erect columns and insert panels safely

Coordinate safe delivery, lifting, line and level on site.

05

Complete coping, topping and inspection

Close interfaces and retain the required handover records.

System value

Why factory-made geometry matters.

Controlled moulds and curing improve repeatability, while site teams concentrate on preparation, lifting, interfaces and safe completion. Final performance still depends on the complete engineered system.

01

Prestressed panel-and-column system

A catalogue-backed characteristic to evaluate against the project programme, design basis and installation method.

02

Catalogue installation procedure available

A catalogue-backed characteristic to evaluate against the project programme, design basis and installation method.

03

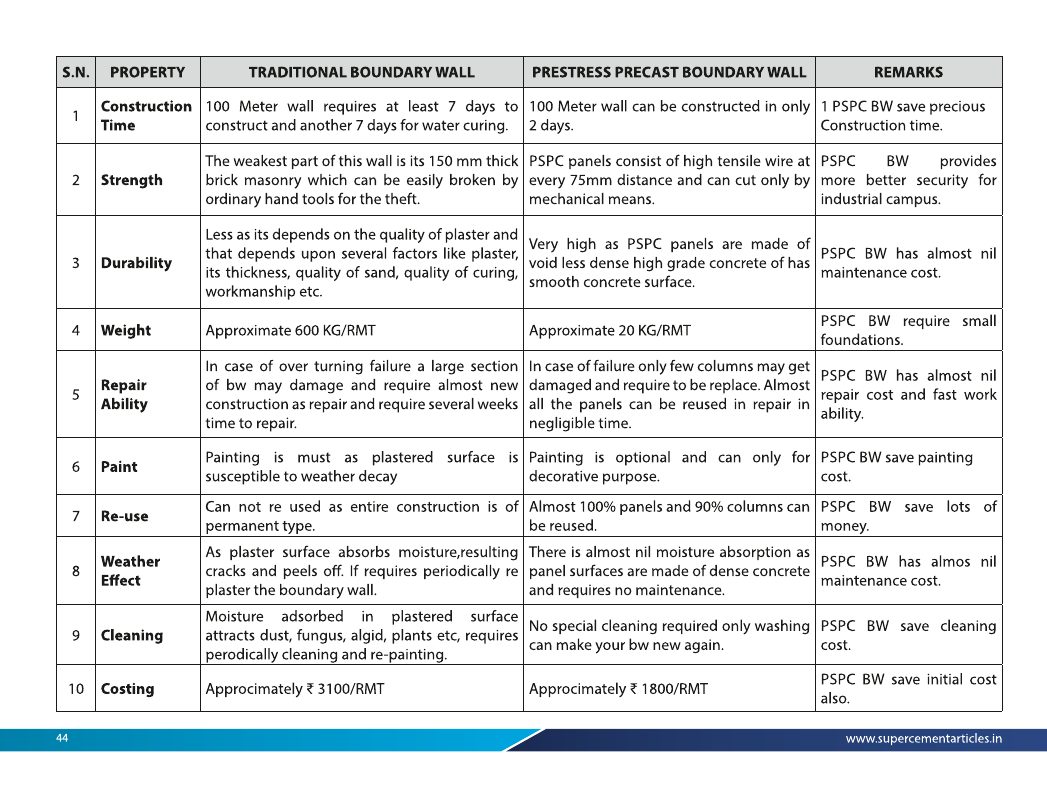

Typical technical details and comparison data

A catalogue-backed characteristic to evaluate against the project programme, design basis and installation method.

04

Suited to long repeatable perimeter runs

A catalogue-backed characteristic to evaluate against the project programme, design basis and installation method.

Frequently asked questions

Prestress Precast Boundary Wall technical FAQs.

Twelve practical questions covering selection, engineering, production, handling, installation and documentation.

What is the benefit of prestressed panels?

Prestressing can support efficient slender precast elements and controlled factory production. The final panel and post design must match project actions and handling.

Does the catalogue provide an installation procedure?

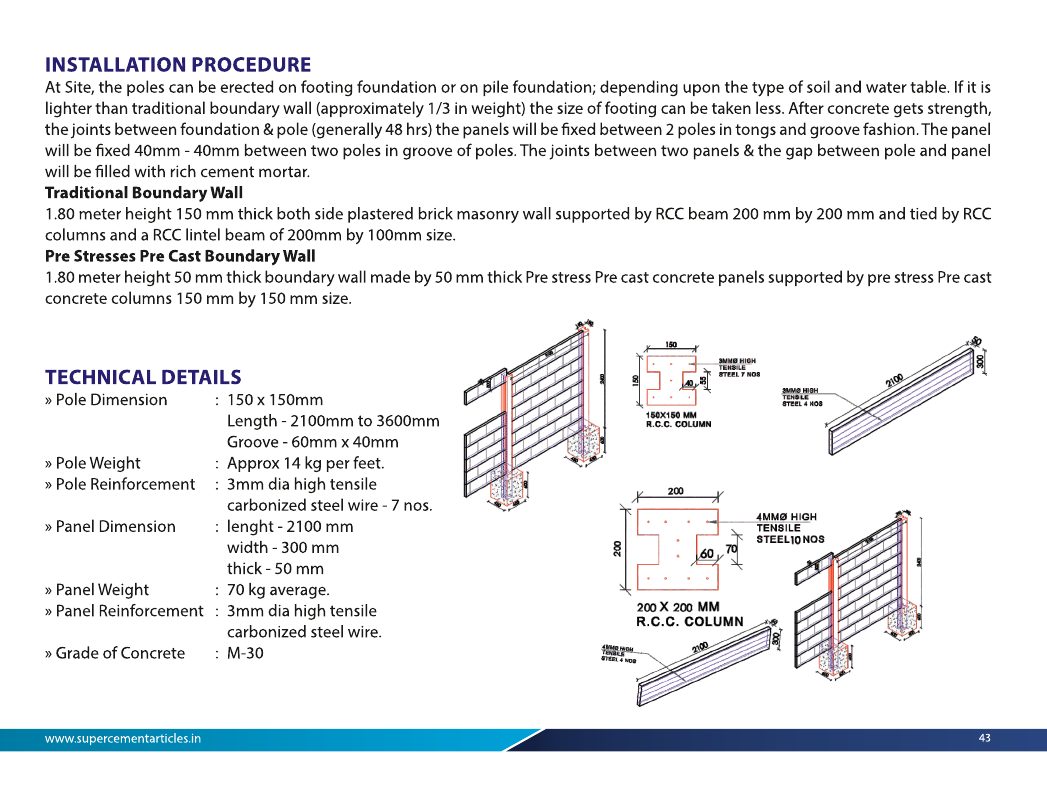

Yes, page 43 illustrates the installation sequence and typical technical details. The project method statement must still reflect actual units, lifting and site conditions.

How soon can panels be installed after footings?

Only after foundation concrete and column restraint meet the approved engineering and method-statement requirements.

Can this wall be used beside railway infrastructure?

Catalogue imagery shows rail-corridor applications, but route authority clearances, loads, access and approvals remain project specific.

Can dimensions or details be customised?

Project-specific dimensions and interfaces can be reviewed before manufacture, subject to engineering, mould and production feasibility.

What is required for a technical quotation?

Share the latest drawings, quantities, application, levels, loading or hydraulic inputs, site location and required programme.

Is project engineering still required?

Yes. The GLB and catalogue explain the product; they do not replace the consultant-approved structural, geotechnical, hydraulic or electrical design.

Can production and dispatch be phased?

Yes, after the unit schedule and technical scope are frozen, manufacture and dispatch can be coordinated to the agreed workfront sequence.

How are units lifted and stored?

Use only approved lifting points, unit weights, equipment and method statements. Stable dunnage, stack height and ground conditions must be planned.

What quality records can be requested?

Applicable drawings, material records and inspection documentation can be discussed for the confirmed product and project scope.

Can existing infrastructure be connected?

Existing levels, dimensions, utilities and tolerances must be surveyed and incorporated into the approved interface details before manufacture.

Can the 3D model be used as a fabrication drawing?

No. The interactive model is for product understanding. Only the latest approved production and project drawings govern manufacture and installation.

Planning a project with Prestress Precast Boundary Wall?

Share the drawings, quantities, site, loading or hydraulic inputs and programme for a product-specific technical discussion.

Start an enquiry
Catalogue reference
